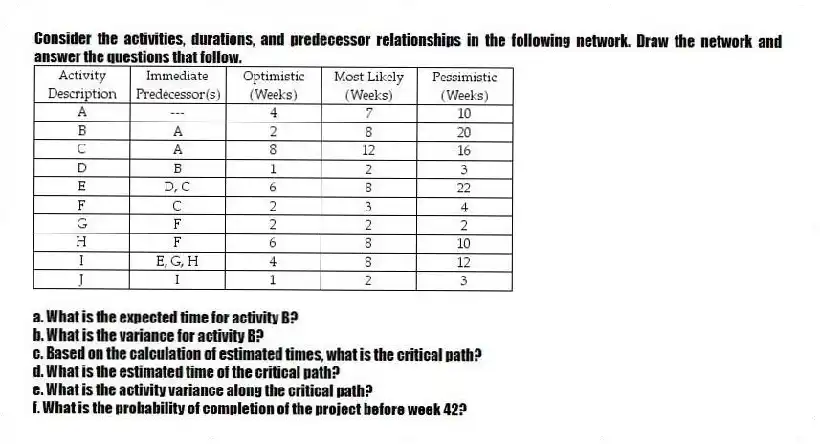

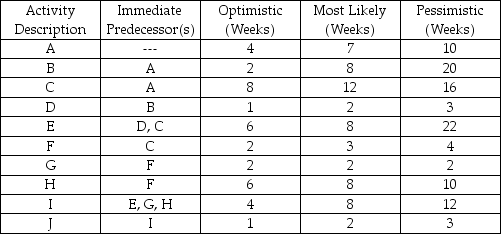

Consider the activities, durations, and predecessor relationships in the following network. Draw the network and answer the questions that follow.
a. What is the expected time for activity B?
b. What is the variance for activity B?
c. Based on the calculation of estimated times, what is the critical path?
d. What is the estimated time of the critical path?
e. What is the activity variance along the critical path?
f. What is the probability of completion of the project before week 42?
Correct Answer:
Verified
a. tₑ =
b. σ² =
View Answer
Unlock this answer now
Get Access to more Verified Answers free of charge
Q118: Table 7.13
All activity times for the project
Q119: Table 7.3 Q120: Table 7.3 Q121: The phase of project management that takes Q122: Table 7.14 Q124: The probability that a project will be Q125: The savvy project manager knew there would Q126: In addition to finishing the work, the Q127: The phase of project management that takes Q128: If the sum of the variances on
You are responsible for managing a
Unlock this Answer For Free Now!
View this answer and more for free by performing one of the following actions
Scan the QR code to install the App and get 2 free unlocks
Unlock quizzes for free by uploading documents
